The construction of sump is progressing quickly. We completed the base slab concreting last week.
ISKCON Chennai Temple Constuction
This blog is to update the Well-Wishers and Devotees in general about the progress of Sri Sri Radha Krishna Temple being built at ISKCON Chennai. This is an interactive group where aspects of temple construction can be discussed and understood. Please feel free to write. Hare Krsna!
Friday, April 8, 2011
Progress of sump construction
The construction of sump is progressing quickly. We completed the base slab concreting last week.
Wednesday, March 30, 2011
March Last Week

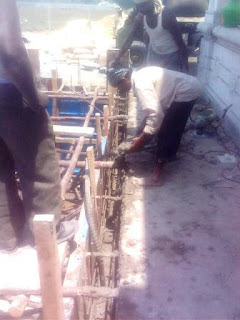

The desgin work of sump is complete and agencies for executing the work have been finalized. On 29th Centering and shuttering labors arrived for starting the sump work. Below is the shuttering material. Steel Reinforcement is being prepared. The excavation work is expected to start on 31march.
Below the PVC coated, GI chain link fence which is ready to be used for boundary wall work on eastern side of temple.
Monday, March 21, 2011
We are on the move
We moved an inch closer...
1. The gate designs were finalized and the orders were placed.
2. The reinforcement for fencing post was completed and they will be cast tommorrow.
3. The fiber tank was moved to complete the remaining stretch of boundary work.
4. The design work is on for underground sump which we plan to take up in April.
5. We met a new sthapati who is TN Govt recognized and showed a lot of interest in our work. His cotract will be finaized in week to follow.
ys
agd
Tuesday, March 15, 2011
Curently following work is happening:
1. Boundary Wall and fencing
2. Sthapati work on northern side
We plan to take up the following work in next few weeks
1. Underground fresh water sump for new temple
2. Fixing the main gates
Soon I will post a tentative schedule for completion of interior work.
Monday, May 14, 2007
Temple Roof Successfully Layed
Sri Sri Radha Madhava ki jai. All glories to Srila Prabhupada!
Its a matter of great pleasure that we have successfully layed the temple roof. It was completed in first week of May. We prayed to Lord Narasingha at Mayapur for the concreting to happen unhindered. We would also like to thank all the donors, life members, well wishers, devotees who have supported and prayed for us.
Now we are moving on to the next stage:
1. Raising the structure above 41ft level for temple domes
2. Remaining plastering and brick work
3. Planning and executing the interiors
Your valuable comments and quires are most welcome.
Warm Regards
Amarendra Gaura Das
Monday, January 22, 2007
Construction Meeting today
Hare Krishna
Today we had the final round of meetings to finalize all pending issues before we proceeded with the laying of first roof slab and beams. The tentative date for concreting of slab is 5th April. The detailed schedule will be up in another two days which will help all of us to keep a tab on whats happening.
To start with we are also strengthening our construction team with an experienced site supervisor and a qualified civil engineer. This is apart from the existing team of resident structural engineer, construction coordinator, Sthapati coordinator and a site supervisor. This is keeping in view the increased number of contractors who will be working at the site as the temple is moving towards completion.
On the other hand, the sthapati has also kept up the pace of work by finishing on more dome over the staircase slab on the south side. Pics will be uploaded soon.
I will be glad to assist if there are any comments of more information is required.
Yours in service of Srila Prabhupada,
Amarendra Gaura Dasa
